Skanska Costain STRABAG JV

AWARD CATEGORY

Rail and transit

Project title

HS2 London tunnels: Rehearsing construction before it happens

Location

London, United Kingdom

Bentley software used

AssetWise, Bentley Infrastructure Cloud, iTwin, iTwin Capture, MicroStation, OpenBuildings, ProjectWise, SYNCHRO

Project summary

SKANSKA COSTAIN STRABAG JV is delivering the final 26.4-kilometer stretch of High Speed 2 from Northolt to Euston in London, with about 95% of the route underground. The project includes complex tunneling, shafts, bridges, and related infrastructure. The team had to coordinate over 75,000 activities and 1.5 million 3D elements. Traditional spreadsheets and static presentations could not provide enough clarity for sequencing and execution risk.

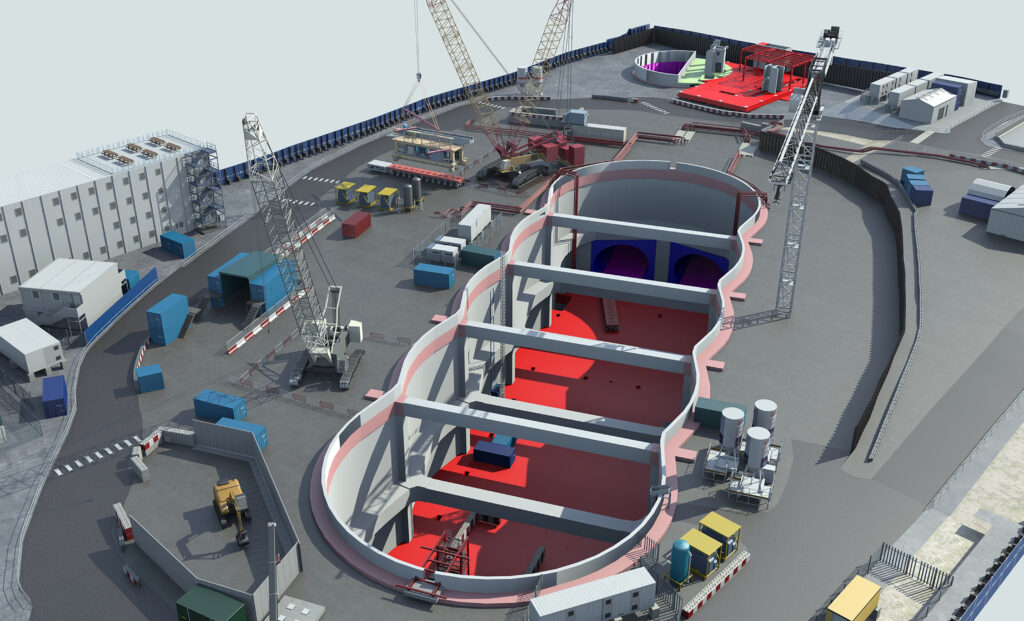

Using Bentley-enabled connected 4D planning, SCSJV rehearsed high-risk work and compared sequencing options before field execution. SYNCHRO 4D Pro supported real-time simulations and optioneering, while Bentley Open applications connected project data and models. The approach supported a 16% schedule reduction on one asset, enabled £23.8 million in cost avoidance, helped achieve a TBM launch six months ahead of plan, and supported the reuse of nearly 2 million tonnes of excavated earth.

Image Credit: Skanska Costain STRABAG JV
